Community Recreation Center
Bond program
Bond Kick-off video
As Redmond rapidly continues to grow in population, the new recreational center will provide enhanced facilities to meet the needs of the community and stand as an investment in future generations.
Currently, the Redmond Area Park and Recreation District (RAPRD) administration and activities are hosted at the only public pool in Redmond – the Cascade Swim Center. Opened in 1979, the swim center catered to a population of about 6,500 people in the recreation district. Now, the district encompasses roughly 45,000 people, which has stretched the Cascade Swim Center in capacity with no room for growth in activities.
RAPRD passed a $49M bond in November 2022 to fund the facility.
After the first design phase and based on the actual concepts, the program team realized that adjustments were needed in order to align the project with the budget and maintain the bond commitments.
This construction of a new recreational facility will sit on 10 acres at SW 35th Street and Lava Avenue in Redmond, and is planned to include both a competitive pool and leisure pool, locker rooms, gymnasium, exercise facilities, group fitness rooms, special event spaces, offices and other administrative/support spaces, and more.
The Redmond Area Park & Recreation District project is a crucial investment in the future of the community. It will provide state-of-the-art facilities, modern amenities, and the ability for growth in adding programs and recreational opportunities for generations to come.

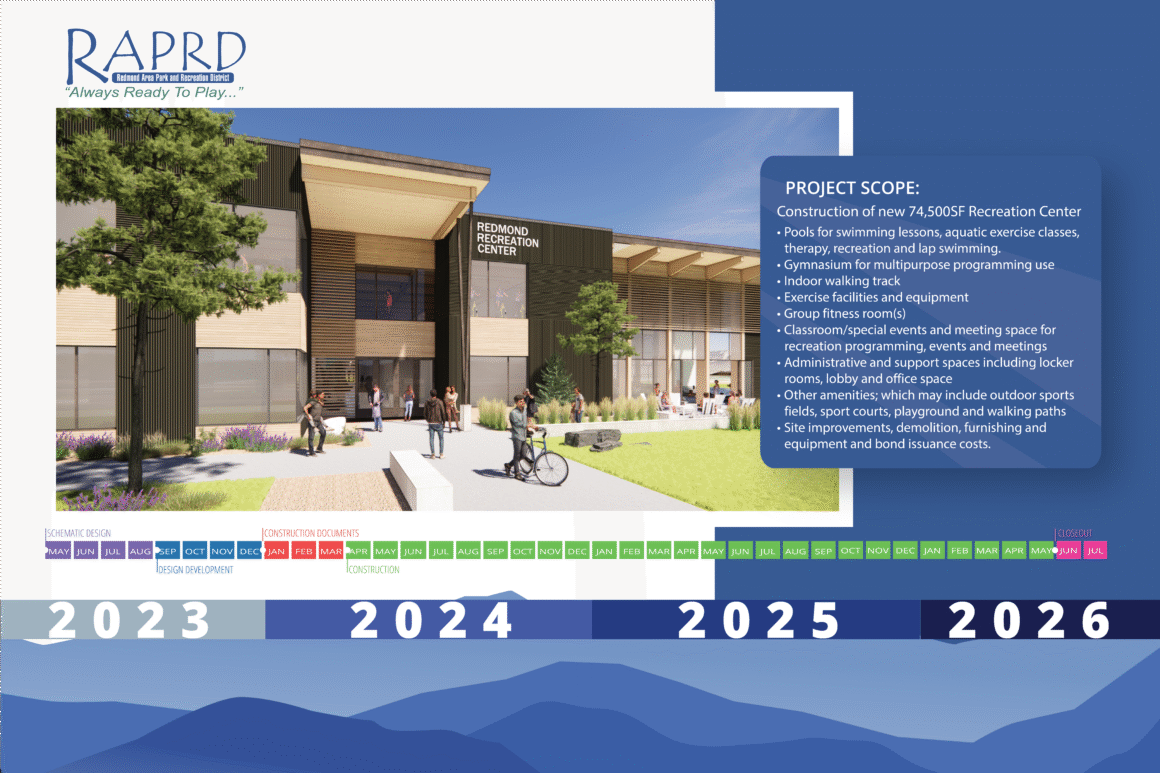

Project
Info and updates
New Redmond Regional Recreation Center, approximately 56,000 square feet
- AQUATICS PROGRAM AREAS
- (8) Lane 25 Meter Competition Pool
- 3,815 sq ft Leisure Pool w/ hot tub
- Water Slide
- 1 Meter Diving Boards
- Aquatic Support Spaces – Lifeguards, Storage, Office
- Outdoor Sun deck
- RECREATION PROGRAM AREAS
- Gym – (1) High School court with (2) Middle School cross courts
- On grade Track – 14 laps per mile
- 2800 sq. ft Fitness – includes cardio, circuit, and weights
- (2) 24-30 Person Group Fitness Classrooms
- COMMUNITY PROGRAM AREAS
- Child watch
- Multipurpose/Party Rooms
- 40-Person Classroom
- Teaching Kitchen
- SUPPORT PROGRAM AREAS
- Small lobby
- Views into Leisure pools
- Locker Rooms
- (4) Family Locker Rooms and Lounge
- Admin Area including (6) private offices and 10 open offices
- Conference Room
- Front Desk w/ small food service
General Program Updates
June was filled with construction activity on site with the contractors continuing to frame the west portion of the building, which houses the gym, exercise facilities, group exercise rooms, multipurpose rooms and administrative spaces. HMK, BRS, and KNCC continued weekly meetings to address any project needs and receive updates.
June Activities
In June, construction of the west side continued with additional sub-contractors brought in to get all ceiling electrical, mechanical, and fire system installed. Concurrently, framing begun in the administrative and multi-use areas of the
building while deconstruction commenced for the natatorium side – removing the roof panels to make way for newly and properly painted purlins. Roofing continued over the locker room portion, with ducting, fire sprinklers, and overhead electrical being installed.
Activities Scheduled For Next Period
In July, a lot of utility coordination will occur. KNCC will trench for permanent power, including work across 35th Ave. and work with Pacific Power to install the transformer. Additionally, gas lines will be installed to the building. On the building, deconstruction and reconstruction of the roof panels and purlins will continue on the east side of the building. Meanwhile on the west side, wall panels, framing, and roofing will be ongoing while the interior continues to be framed with plumbing, electrical and mechanical work continuing.
